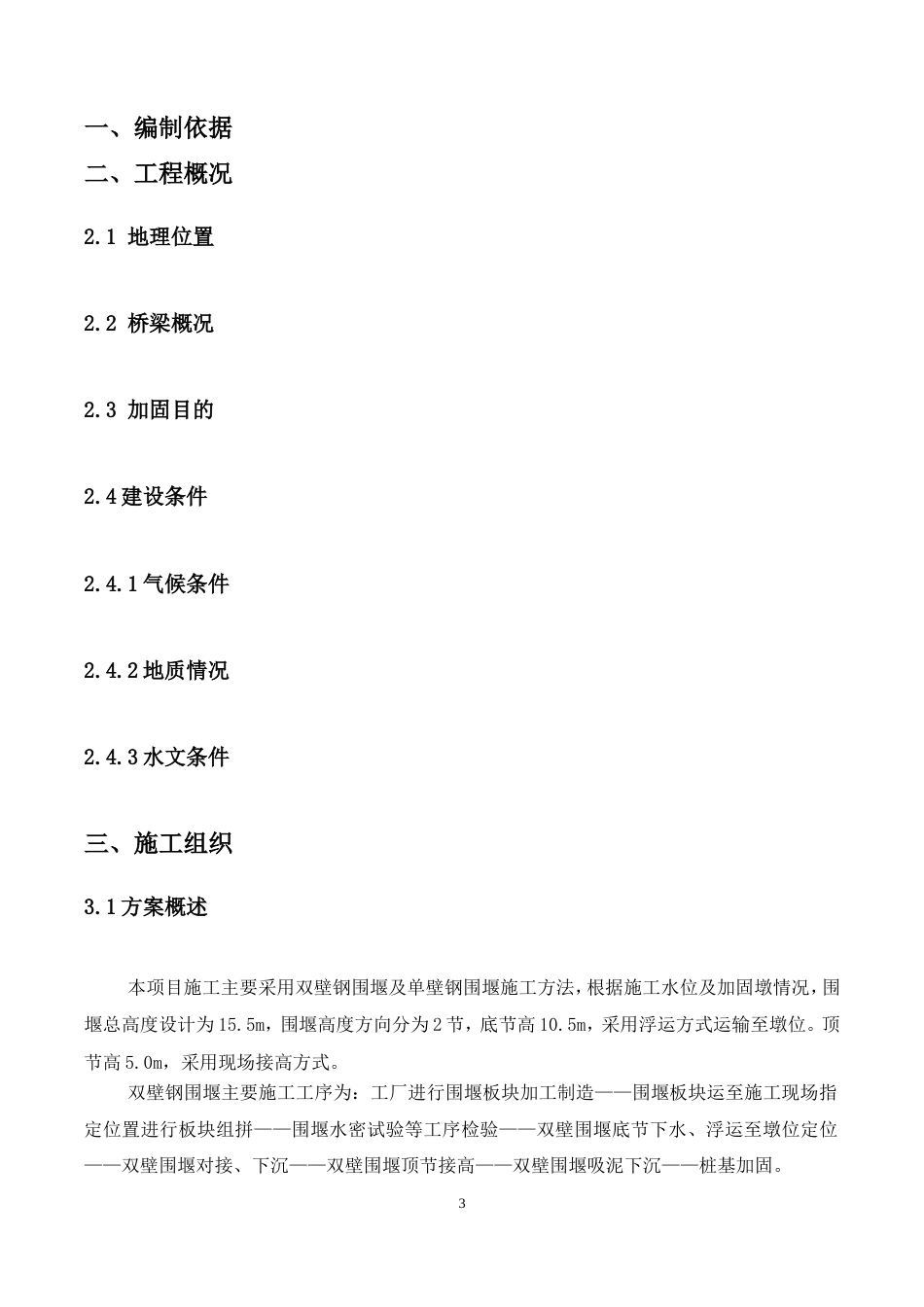

双壁钢围堰专项施工方案 编 制: 复 核: 审 批: 中铁大桥局股份有限公司1目 录一、编制依据.................................................................1二、工程概况.................................................................12.1 地理位置................................................................12.2 桥梁概况................................................................22.3 加固目的................................................................22.4 建设条件.................................................................3三、施工组织.................................................................43.1 方案概述.................................................................43.2 施工步骤.................................................................53.3 工期安排.................................................................93.4 人员组织................................................................113.5 机械设备组织............................................................12四、施工方案................................................................134.1 双壁钢围堰结构设计......................................................134.2 双壁钢围堰施工结构流程..................................................154.3 双壁钢围堰板块制造......................................................154.4 双壁钢围堰拼装..........................................................204.5 双壁钢围堰下河..........................................................224.6 围堰浮运................................................................284.7 底节围堰就位及合拢......................................................314.8 底节围堰注水下沉........................................................334.9 顶节围堰接高............................................................344.10 围堰吸泥下沉..........................................................344.11 围堰封底施工..........................................................35五、质量保证措施............................................................395.1 施工前的质量控制........................................................395.2 施工过程的质量控制.....................................................39六、施工安全控制............................................................406.1 安全管理目标............................................................406.2 安全管理组织机构........................................................416.3 安全保证措施............................................................436.4 水上安全应急预案........................................................47七、文明施工及环保..........................................................537.1 文明施工措施............................................................537.2 环境保护措施............................................................53附件:单个 U 型围堰浮运阻力计算..............................................552一、编制依据二、工程概况2.1 地理位置2.2 桥梁概况2.3 加固目的2.4 建设条件2.4.1 气候条件2.4.2 地质情况2.4.3 水文条件三、施工组织3.1 方案概述本项目施工主要采用双壁钢围堰及单壁钢围堰施工方法,根据施工水位及加固墩情况,围堰总高度设计为 15.5m,围堰高度方向分为 2 节,底节高 10.5m,采用浮运方式运输至墩位。顶节高 5.0m,采用现场接高方式。双壁钢围堰主要施工工序为:工厂进行围堰板块加工制造——围堰板块运至施工...
